You’re reading this article, which means you either just discovered Taubyte or want to learn more about what it is and how it works. Well, let’s start with what it is, and then we will dive into how it works using an amazing tool we call dreamland.

What is Taubyte?

Taubyte simplifies the process of building a cloud computing platform, making it a no-brainer. Unlike other products, such as Kubernetes, which were not designed with software developers in mind nor as platforms, Taubyte eliminates the need for DevOps and platform engineering. In essence, Taubyte is designed for software developers, requiring no DevOps nor platform engineering skills. To achieve this, we aimed not just for automation but for autonomy.

If you’re a DevOps professional reading this, you might think it sounds too good to be true, or perhaps you’re inclined to deny its feasibility, fearing it will make your job obsolete. However, I invite you to stay with us because Taubyte is as real as it is open source. Moreover, I believe it will give DevOps and Platform Engineers an unprecedented advantage.

Let’s get our hands dirty!

The best way to learn something is by doing it, and that’s exactly what we’re going to do. All you need is npm. While there are other methods, we’ll stick to npm as it’s the simplest and most widely available, even on Windows.

What we’ll do is install dreamland, a project hosted on github.com/taubyte/dreamland that allows you to run a Taubyte-based Cloud Computing Platform locally. It’s an excellent tool for local development and testing, but we’ll use it in a slightly different way.

Run the following command to install dreamland:

$ npm i @taubyte/dream

Now, you should have the dream command-line tool available. Let’s start a cloud:

$ dream new multiverse
[INFO] Dreamland ready
[SUCCESS] Universe blackhole started!

You can ignore any ERROR messages you might see about seer.

Once you see SUCCESS, it means your cloud has been fully started.

A first look

First, let’s explore what’s happening using the command line. Run:

$ dream status universe

This should output something like:

┌───────┬─────────────────────┬────────┬───────┐
│ Nodes │ elder@blackhole     │ p2p    │ 14051 │
│       ├─────────────────────┼────────┼───────┤
│       │ tns@blackhole       │ http   │ 14466 │
...

This lists all the running nodes. Each node could be running a specific protocol (e.g., tns or substrate) and will reflect that. Others will have a role like elder (bootstrap node) or client.

Also, @blackhole indicates that the node is part of the blackhole universe. Each universe represents a cloud and is cryptographically isolated from any other cloud on the peer-to-peer layer.

On the right side, you can see the TCP ports each node is using along with the number of copies.

Now, let’s leave the terminal and head to console.taubyte.com where you’re going to locate the Dreamland button. Then click on it.

The button will be disabled or hidden if dreamland is not detected.

Now, locate the sidebar: (1) click on Network, then (2) on blackhole.

After a few seconds, you should see something similar to:

On the network graph, which you can manipulate, you can see all the same nodes as before from the CLI.

If you hover over any node, it’ll display the TCP ports it’s using.

What’s with the mesh network?

Hosts, or as we call them, Nodes, form a Taubyte-based Cloud Computing Platform and communicate with each other using a peer-to-peer network. Running locally through dreamland, all the nodes are interconnected, although this might not always be the case in production, especially if you have many nodes.

The peer-to-peer nature of Taubyte-based clouds gives them important characteristics like resilience and redundancy.

Protocols

While in production a node can run multiple protocols by defining a shape (a term reminiscent of the internal name tau had: odo, a reference to the shape-shifting Star Trek character), in dreamland, each node runs only one protocol. This design choice simplifies protocol debugging.

Without further ado, here’s what each protocol does:

  • auth handles token validation and secret management.
  • tns ensures project registry consistency across the cloud.
  • seer is responsible for DNS resolution and load balancing.
  • patrick bridges git events into CI/CD jobs.
  • monkey executes CI/CD jobs.
  • hoarder manages replication.
  • substrate handles request processing and serving.
  • gateway manages L7 load-balancing.

The other nodes

The other nodes, referred to as Simples (admittedly, not the best name), include elder and client. While they are not crucial for the purpose of this article and could be excluded when starting the universe, it’s helpful to understand their intended roles:

  • elder nodes are used for bootstrapping. Since dreamland interconnects all nodes, an elder is included for testing purposes when using libdream.
  • client nodes are lightweight and can be used to test protocols or peer-to-peer services deployed on the cloud.

Note: Some fixtures, which will be covered in another article, may require Simples to function correctly.

Creating a project

Now, let’s create a project on this cloud. Although it can be done using tau-cli, which you might prefer if you’re a terminal enthusiast like me, we’re going to use the Web Console instead.

Open a new browser window or tab and navigate to console.taubyte.com.

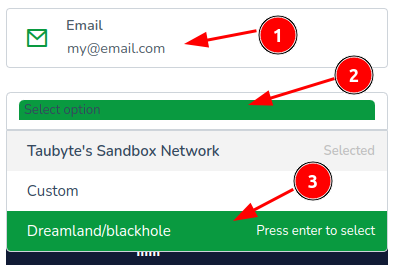

(1) Type your email, then (2) click on the network selection input, and finally (3) click on Dreamland/blackhole.

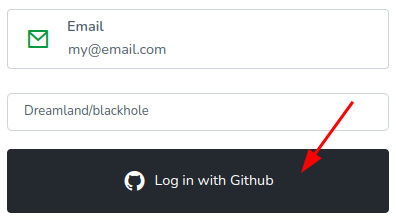

Next, click the Login with GitHub button.

You will be asked to grant the app GitHub access. This access is local to your browser and is used to create repositories related to your project, which will be cloned into a browser-based virtual file system.

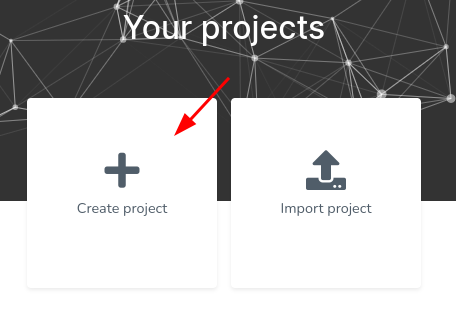

The next screen will display “Your projects” and should show no projects. You’ll want to click on Create project.

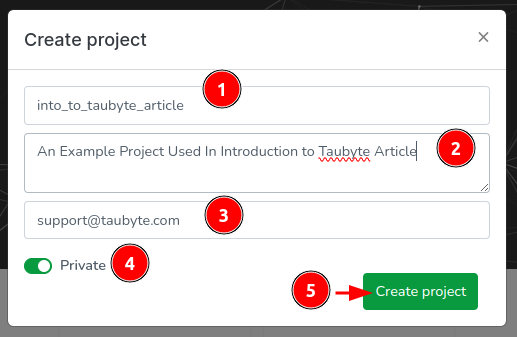

Enter a project name, a description, toggle private (unless you want the project repositories to be public), then click on Create Project.

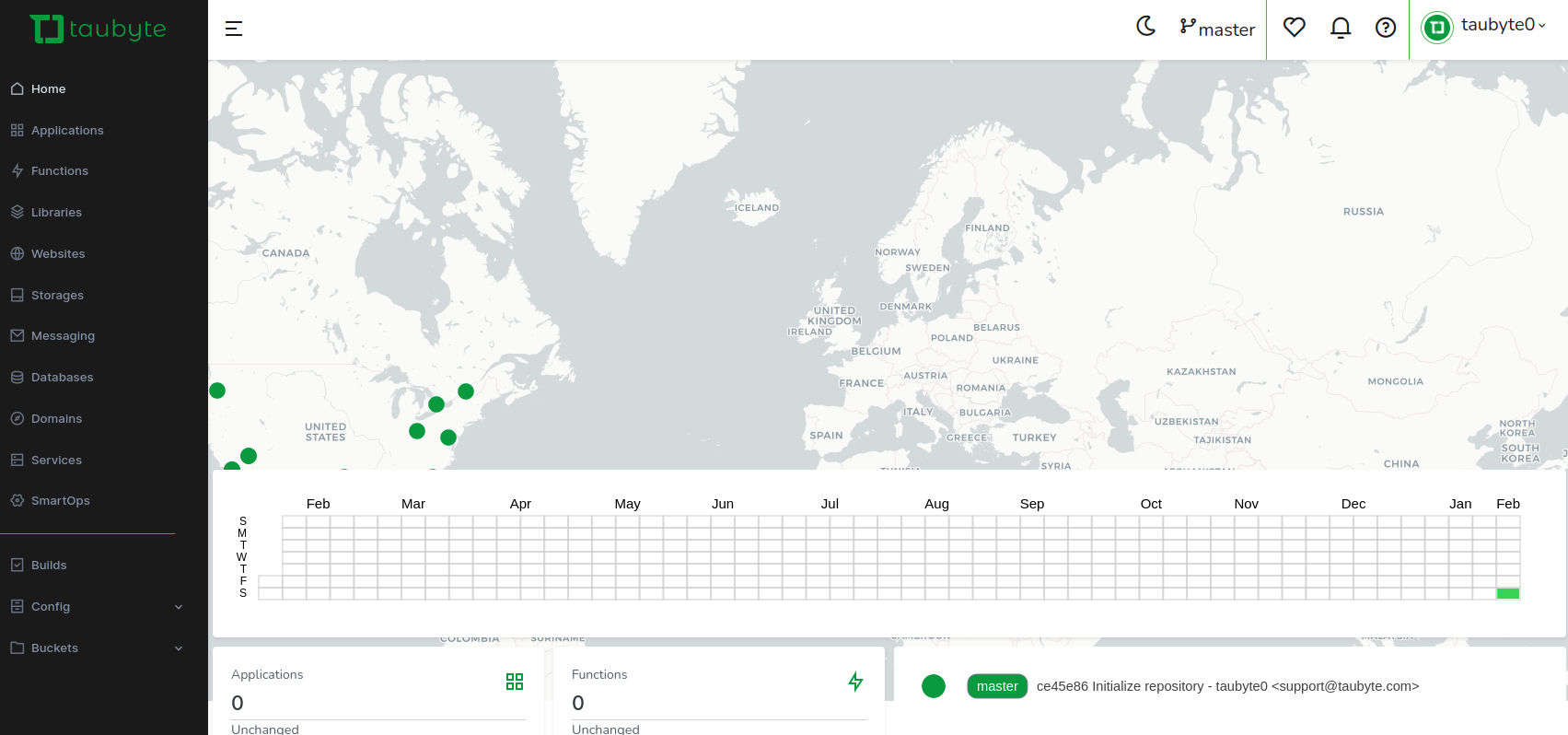

The Web Console will create two repositories: one for configuration, containing mainly YAML files, and another for inline code, containing code in different languages to be compiled to WebAssembly. If everything goes well, you’ll be directed to the dashboard.

Creating a Function

Taubyte-based Clouds support serverless functions. Let’s create one!

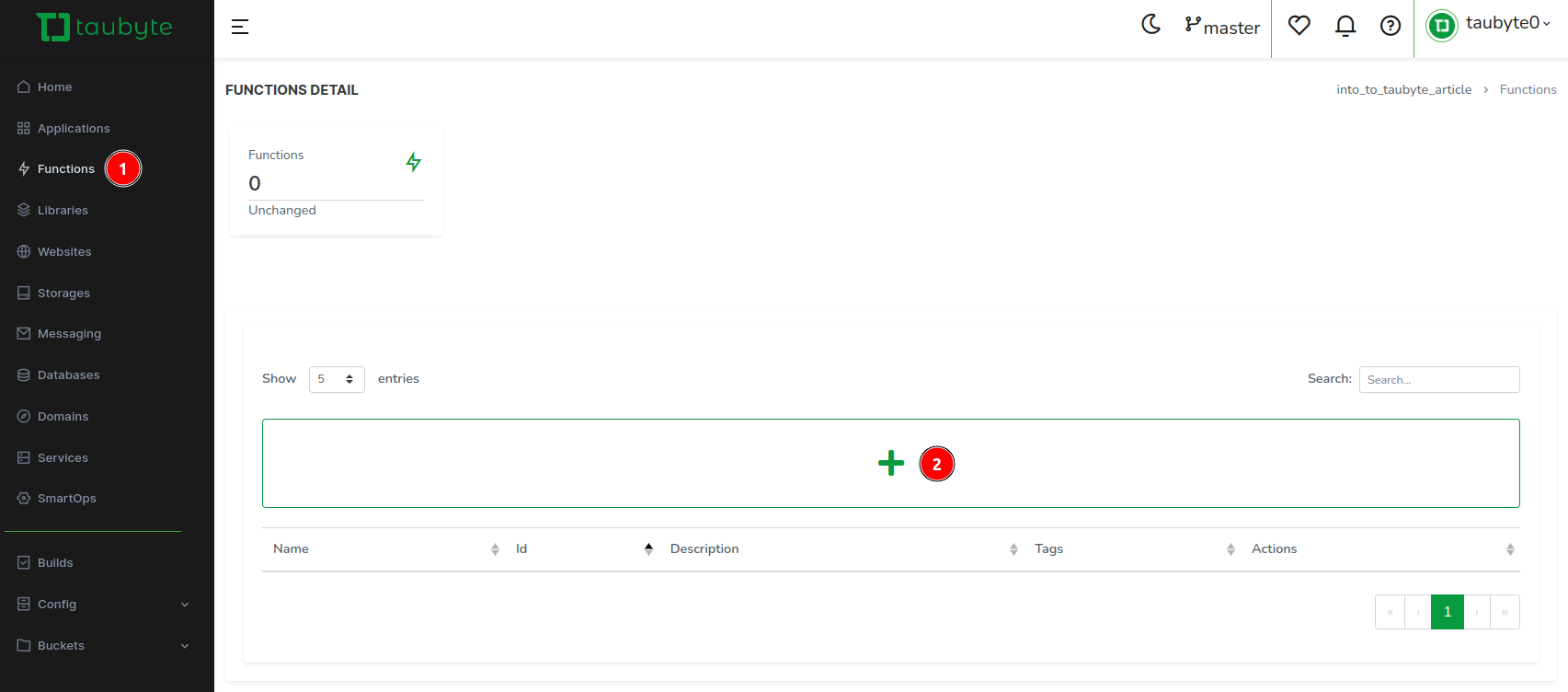

Click on Functions in the side menu, then on the + button.

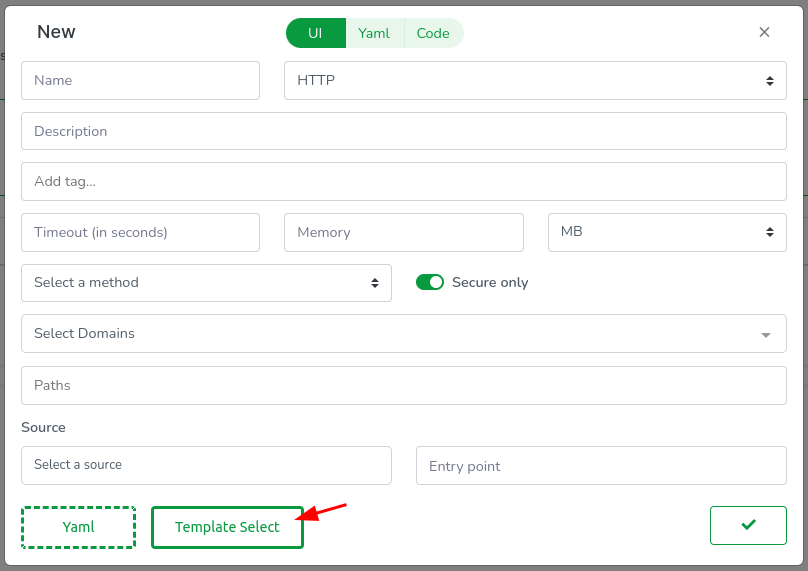

To expedite the process, we’ll use a template. Skip filling any field for now and click on the Template Select button.

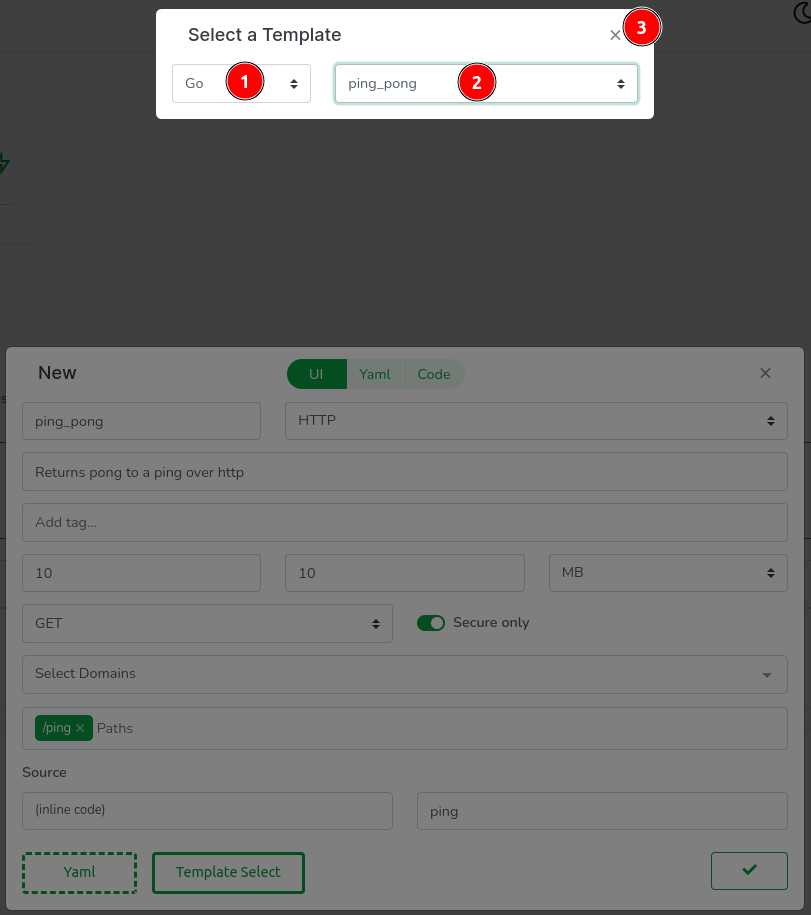

This action opens another modal at the top where you can select a template. Although you can choose Go, Rust, or AssemblyScript at the time of writing this article, we’ll keep it simple and go for Go! (pun intended). So: (1) select Go, (2) select ping_pong, and finally (3) close the modal.

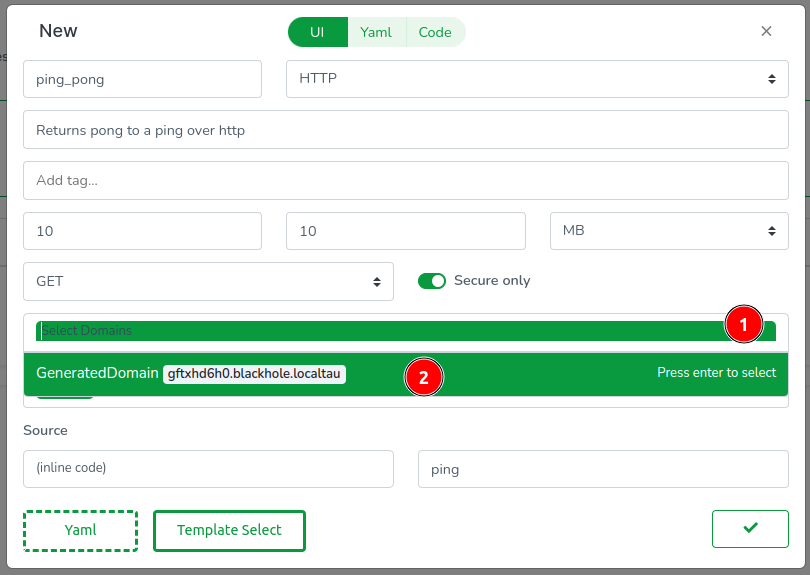

All fields have been automatically filled except for the domains. Proceed by (1) clicking on the list and (2) selecting GeneratedDomain. This action will create a domain resource for you.

It’s worth noting that the Web Console clones your repositories in-browser, meaning there’s always a code equivalent to everything you do. Let’s review the YAML config by clicking on the Yaml tab.

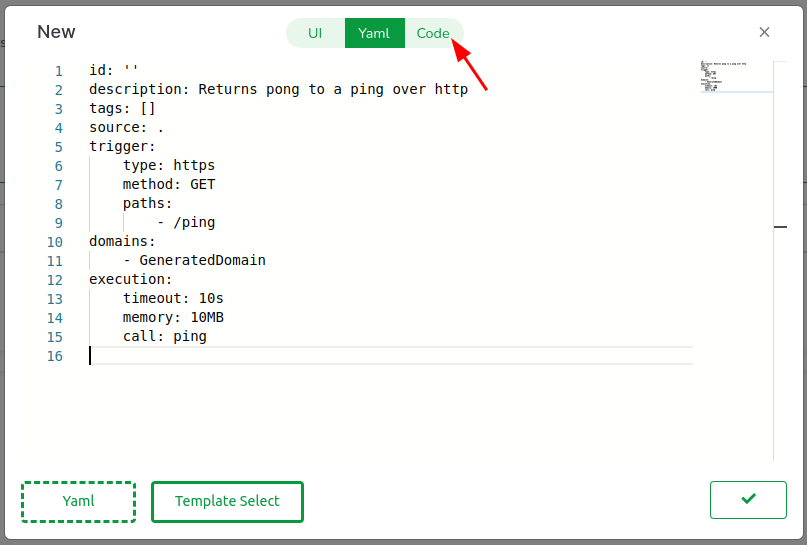

You will see YAML code resembling the following:

id: ""
description: Returns pong to a ping over HTTP
tags: []
source: .
trigger:
  type: https
  method: GET
  paths:
    - /ping
domains:
  - GeneratedDomain
execution:
  timeout: 10s
  memory: 10MB
  call: ping

Most of this YAML should be self-explanatory, but let me clarify a few points:

  • source: can either be . for inline code or the name of a library (to be explored in other articles).
  • execution.call: specifies the function to be executed and must be exported by the WebAssembly module.

Next, let’s inspect the code. The Web Console features a modest code editor useful for quick inline code updates. Access it by clicking on the Code tab.

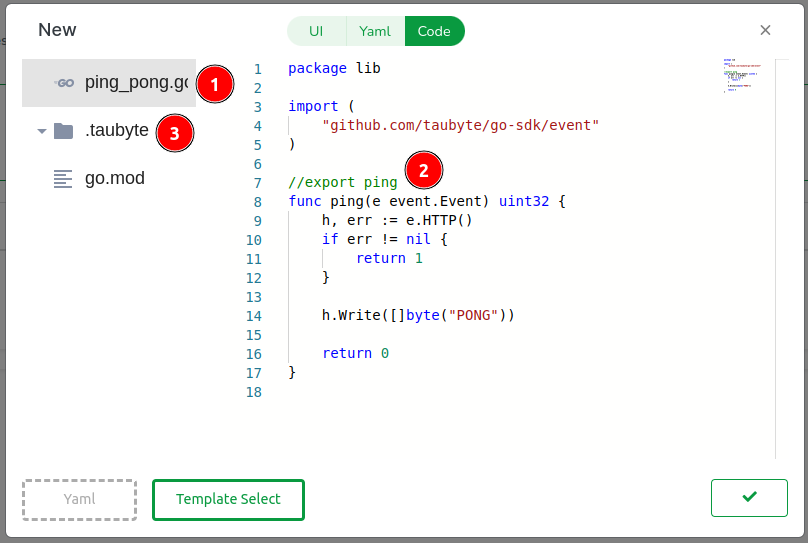

In the editor, you will observe (1) the usual Go files including go.mod, (2) the code for our handler function ping, and (3) a .taubyte folder defining how the function is built.

While understanding the entire code or mastering Go isn’t necessary, I’ll explain a few basic concepts that will map in a way or another to any serverless function in supported languages:

  • The package name can be anything except main. The building container, taubyte/go-wasi on Docker Hub, wraps your function in a special main function.
  • The github.com/taubyte/go-sdk package simplifies interactions with the Taubyte VM, making it straightforward to use VM primitives.
  • We use tinygo to compile Go into small, efficient WebAssembly modules. To export a function, annotate it with the //export comment.
  • Taubyte supports various trigger types, so handlers receive an event. We care about efficiency, so event.Event is really a wrapper of a uint32, minimizing unnecessary memory allocation and copying.

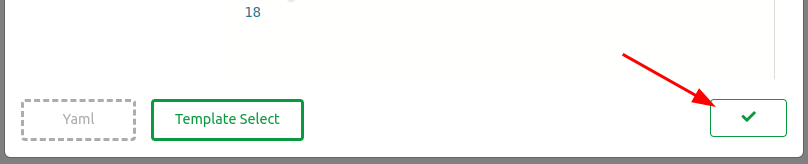

Click Done to proceed.

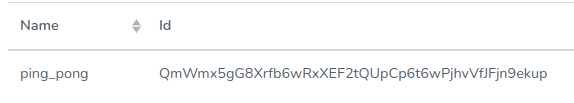

The function should now appear listed.

Everything done so far is confined to the virtual filesystem in your browser. To apply these changes, we need to push them. Find the green button at the bottom right of the screen and click on it.

A modal will guide you through the code changes, starting with configuration changes. Click on the domains folder, then open the GeneratedDomain.yaml file.

Copy the FQDN generated for you as we will need it later:

fqdn: gftxhd6h0.blackhole.localtau

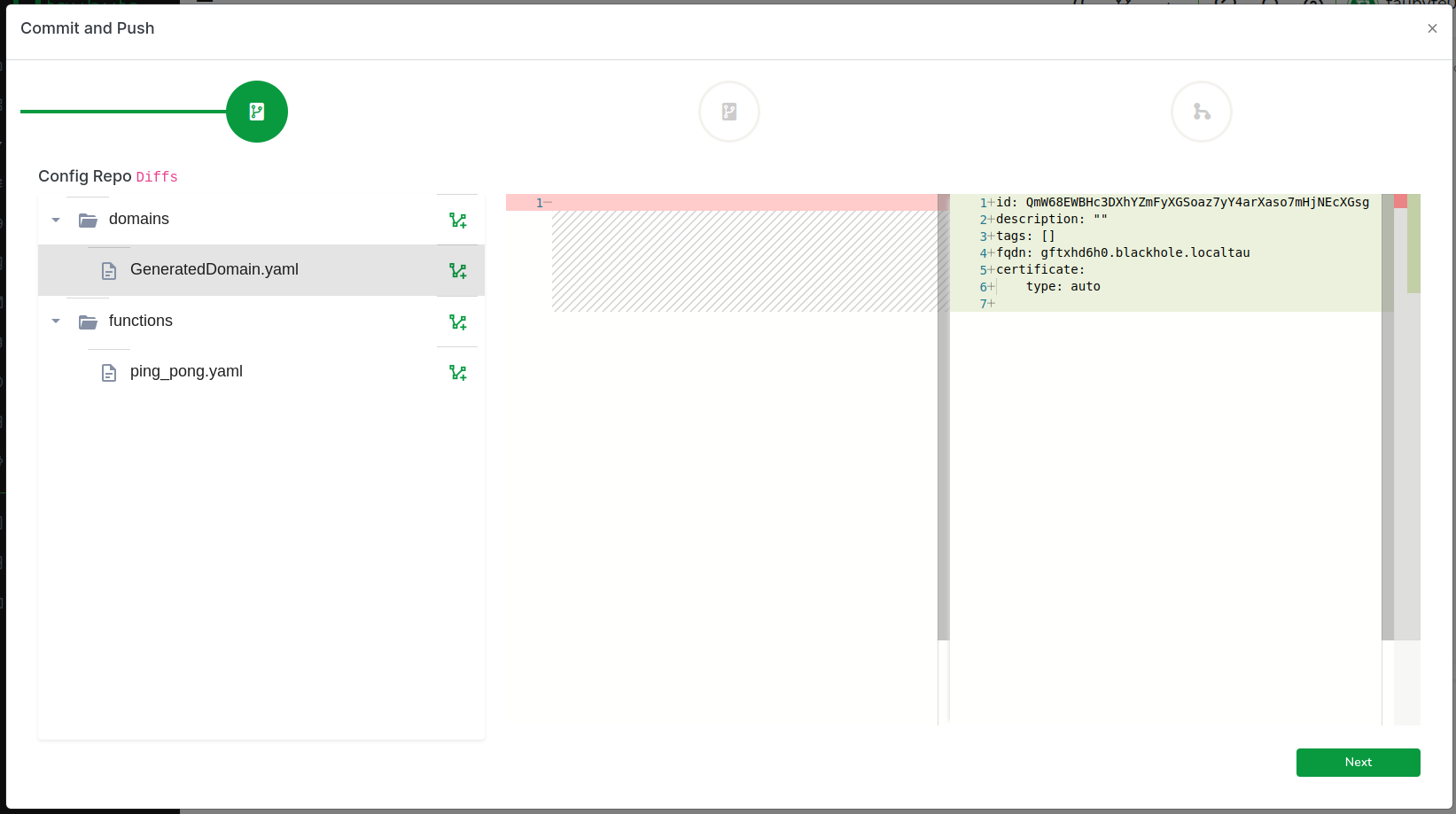

Click on Next to review code changes.

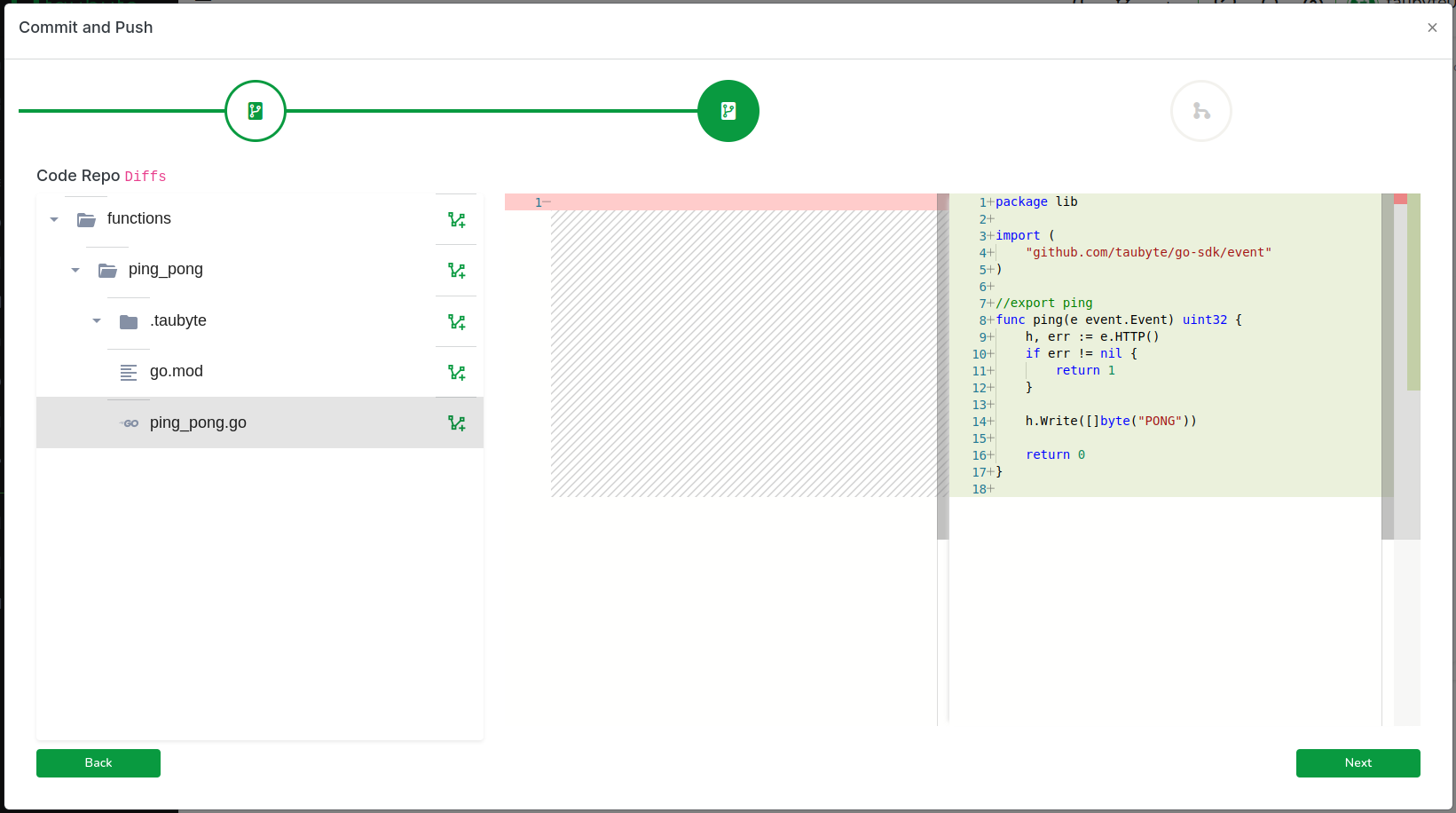

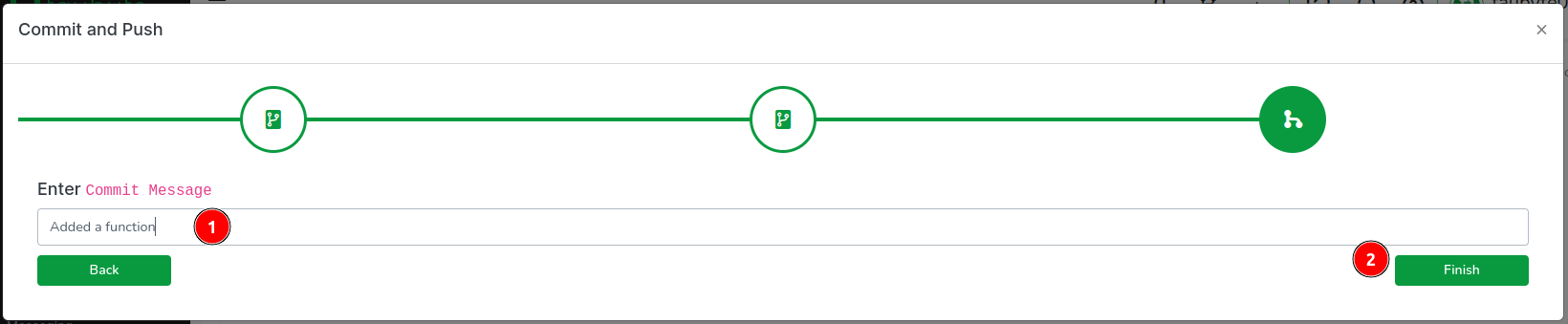

One more click on Next takes you to the final step, where you’ll (1) enter a commit message and (2) push the changes to GitHub.

In production, this push would trigger an event captured by patrick. However, because we’re using dreamland and GitHub cannot reach your nodes directly, we run a fixture called push-all to emulate the git events. Switch back to your terminal and run:

$ dream inject push-all

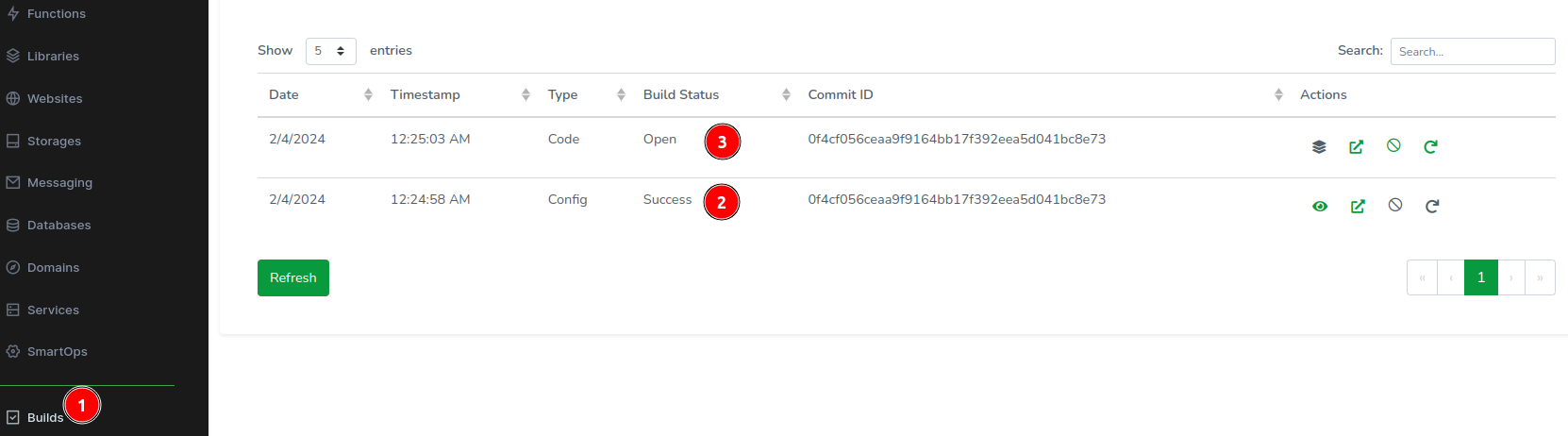

Return to the Web Console and, on the side menu, click on Builds. You should see two CI/CD jobs, one for configuration and one for code.

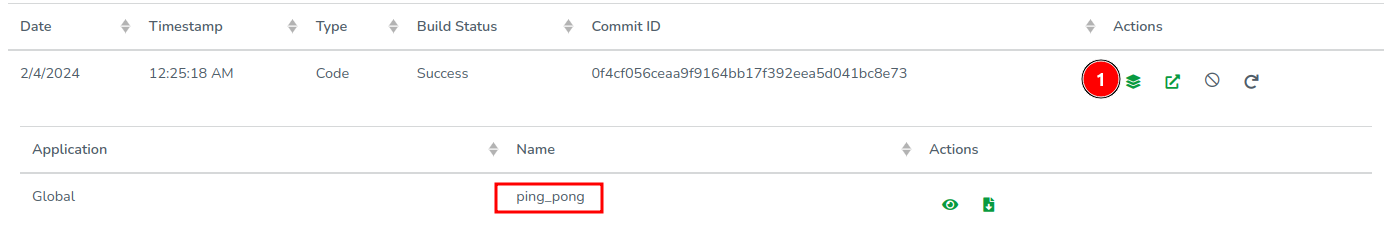

After a few seconds, the build should complete. Click on Refresh if it seems delayed. Then, click on the stack icon to view the ping_pong function.

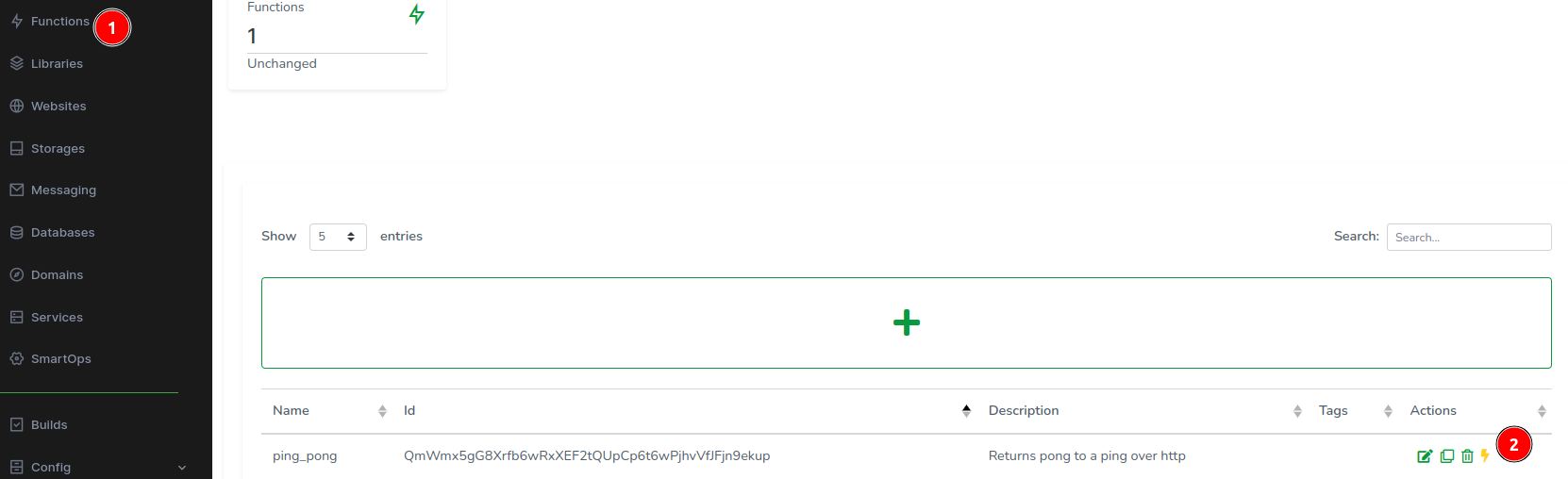

Executing the Function

Now that our function has been built and its configuration published on tns, we can execute it by hitting the endpoint. Since we’re running a local cloud, we need to find out which port the substrate (or gateway, if you’re using one) node uses to handle HTTP requests. To do this, run:

$ dream status substrate

In my case, the HTTP port is 14529.

┌─────────────────────┬────────┬───────┐
│ substrate@blackhole │ copies │     1 │
│                     ├────────┼───────┤
│                     │ dns    │ 14304 │
│                     ├────────┼───────┤
│                     │ http   │ 14529 │
│                     ├────────┼───────┤
│                     │ p2p    │ 14282 │
└─────────────────────┴────────┴───────┘

You can test the function using curl as follows, making sure to replace gftxhd6h0.blackhole.localtau with your own generated domain:

$ curl -H "Host: gftxhd6h0.blackhole.localtau" http://127.0.0.1:14529/ping

Output:

PONG

Alternatively, you can add the generated domain to your local hosts file (/etc/hosts in my case) as follows:

$ sudo vi /etc/hosts
127.0.0.1 gftxhd6h0.blackhole.localtau

Save and exit, then run curl again but without the Host header:

$ curl http://gftxhd6h0.blackhole.localtau:14529/ping

Output:

PONG

If you’ve added the generated domain to your /etc/hosts, you can also use the Web Console to hit the function’s endpoint: (1) In the sidebar, click on Functions, then (2) click on the thunder icon.

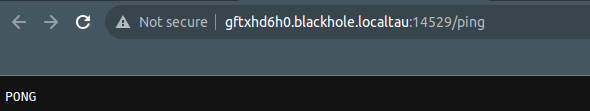

This action opens a new tab where you should see something like this:

Congratulations! You’ve successfully created a cloud and executed a serverless function on it!

What Just Happened!

In this section, we’ll take a step back to review the processes and protocols involved in each step of deploying and executing a serverless function with Taubyte. This overview will help clarify the interactions between different components and the significance of each protocol in the overall architecture.

Project Creation

The creation of a project is predominantly a client-side operation, facilitated by either the Web Console or the tau-cli. This process involves direct communication with GitHub to establish the necessary repositories. Only towards the end does the auth protocol come into play, tasked with registering these repositories. This registration process includes storing critical secrets such as the deployment key, essential for cloning code during CI/CD processes, and the webhook secret, used to authenticate events coming from GitHub.

The sequence diagram below illustrates these interactions in detail:

sequenceDiagram
    participant Client as Web Console/tau-cli
    participant GitHub
    participant Auth as auth

    Note over Client,GitHub: Project creation initiated on client side
    Client->>GitHub: Create repositories
    Note over GitHub: Repositories and necessary metadata created

    GitHub-->>Client: Confirm repository creation
    Note over Client,Auth: Only at the end does auth play a role

    Client->>Auth: Register repositories
    Note over Client,Auth: Includes storing deployment key and webhook secret

    Auth-->>Client: Confirm registration and storage of secrets

Pushing Changes to GitHub

When changes are pushed to GitHub, a sequence of events is triggered, initiating a process that involves multiple protocols to manage and execute CI/CD jobs. The patrick protocol plays a pivotal role in verifying the legitimacy of events and creating jobs, while the monkey protocol is responsible for the execution of these jobs. Subsequently, the tns stores and replicates the compiled configuration, and the hoarder protocol ensures the replication of updated assets.

The sequence diagram below visualizes this workflow:

sequenceDiagram
    participant GitHub as GitHub
    participant Patrick as Patrick
    participant Monkey as Monkey
    participant TNS as TNS Protocol
    participant Hoarder as Hoarder

    Note over GitHub,Patrick: git push

    GitHub->>Patrick: Github Web Hook
    Patrick->>Patrick: Verify events are legit
    Patrick->>Patrick: Create jobs for events

    Patrick-->>Monkey: Broadcast jobs
    Note over Monkey: Bid for the job(s)

    Monkey->>Monkey: Job Execution
    Note over TNS: Assuming successful job execution

    Monkey->>TNS: Publish configuration

    Monkey->>Monkey: File chunked, structured in DAG

    Monkey->>TNS: Update Asset CIDs

    Monkey-->>Hoarder: Notify of new CID
    Hoarder->>Hoarder: Replicate

    Note over Monkey,Hoarder: Replicated by at least one node

It’s important to note that because we are using Dreamland, a simulated environment, there’s no direct way for GitHub to communicate with your nodes. This limitation is addressed by using the fixture called push-all, which emulates the git events that would typically trigger the CI/CD process in a production environment.

Hitting the Endpoint

The process for handling a request at an endpoint varies depending on the network’s configuration. In a simple setup without gateways and HTTPS, the request’s host name is resolved by the seer protocol before the request itself is processed by a substrate node. However, in networks with gateways or HTTPS requests, additional steps, like retreiving x509 certificate from auth, are involved.

The diagrams below detail these processes for different configurations:

  • Without Gateway and HTTPS:
sequenceDiagram
    participant Client
    participant Seer as Seer
    participant Substrate
    participant TNS as TNS
    participant Peers as Other Peers

    Client->>Seer: Resolve Host
    Seer-->>Client: Nearest Substrate IP
    Client->>Substrate: HTTP request

    Substrate->>TNS: Lookup function
    TNS-->>Substrate: Returns config

    Substrate->>Peers: Request WebAssembly module
    Peers-->>Substrate: Download WebAssembly module

    Substrate->>Substrate: Execute handler
    Substrate-->>Client: Relay response
  • With Gateway:
sequenceDiagram
    participant Client
    participant Seer as Seer DNS
    participant Gateway
    participant Substrate

    Client->>Seer: DNS query for endpoint
    Seer-->>Client: Resolve to nearest Gateway IP
    Client->>Gateway: HTTP request

    Gateway->>Substrate: Establish p2p connection to Substrates
    Gateway->>Substrate: Tunnel HTTP to best Substrate
    Note over Gateway,Substrate: Handling by Substrate is similar to before
  • With HTTPS:
sequenceDiagram
    participant Client
    participant Gateway_Substrate as Gateway/Substrate
    participant Auth as Auth Protocol

    Client->>Gateway_Substrate: HTTPS request
    Gateway_Substrate->>Auth: Request certificate
    Auth-->>Gateway_Substrate: Return certificate
    Gateway_Substrate-->>Client: Return certificate to Client

    Note over Gateway_Substrate,Client: Secure connection established

Note: Taubyte supports the Automatic Certificate Management Environment (ACME) protocol for auto-generating certificates using Let’s Encrypt.

These diagrams demonstrate the seamless and autonomous nature of the Taubyte platform, which requires no manual configuration and ensures a smooth deployment and execution process for serverless functions.

Conclusion

This guide has introduced you to Taubyte, illustrating its approach to simplifying cloud computing for developers. By walking you through the creation of a cloud environment and deploying a serverless function, we’ve showcased Taubyte’s exceptional developer experience and practicality. Our hands-on approach aimed to highlight the ease with which developers can leverage Taubyte to create and manage cloud environments without the complexities traditionally associated with cloud computing.

Taubyte is designed to empower developers, enabling you to focus on innovation rather than infrastructure. Whether you’re taking your first steps into cloud computing or looking to optimize your development workflow, Taubyte provides a streamlined, developer-centric platform that simplifies cloud creation and management.

As you continue to explore Taubyte, remember that this introduction is just the starting point. Taubyte’s open-source nature invites you to dive deeper, experiment, and contribute to its evolving ecosystem. Welcome to a new era of cloud computing with Taubyte, where creating clouds is as intuitive as developing software.
